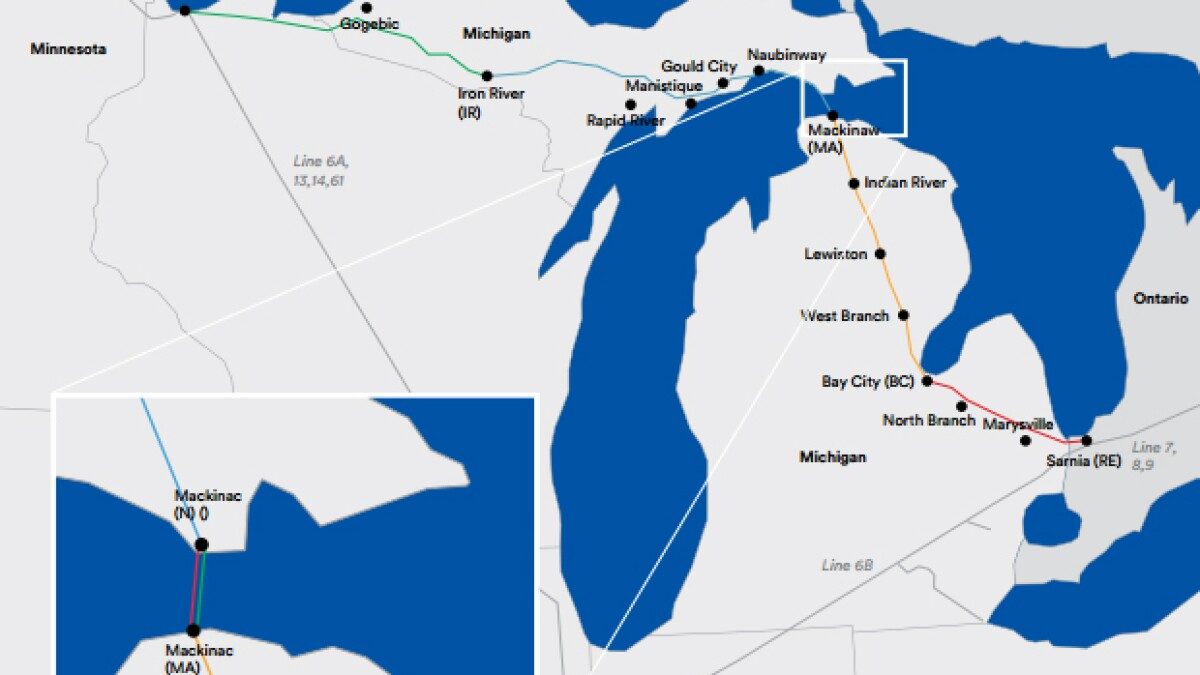

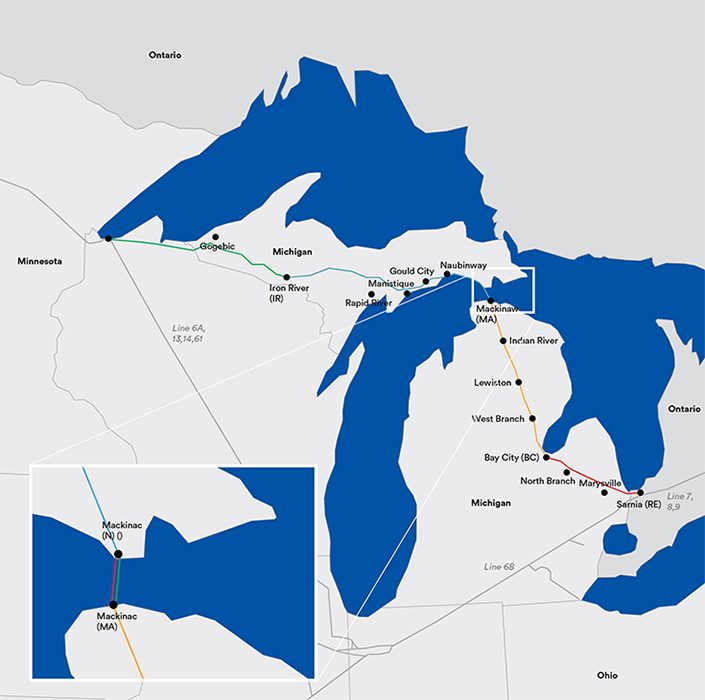

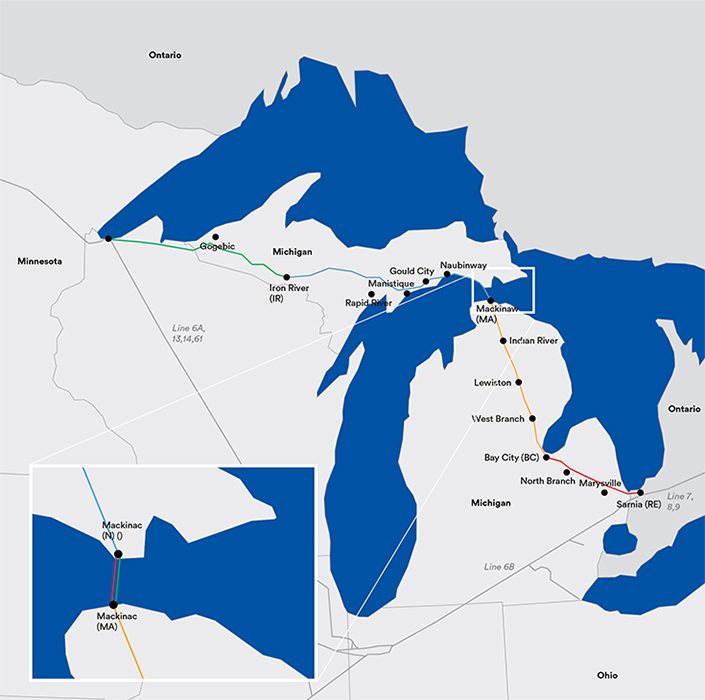

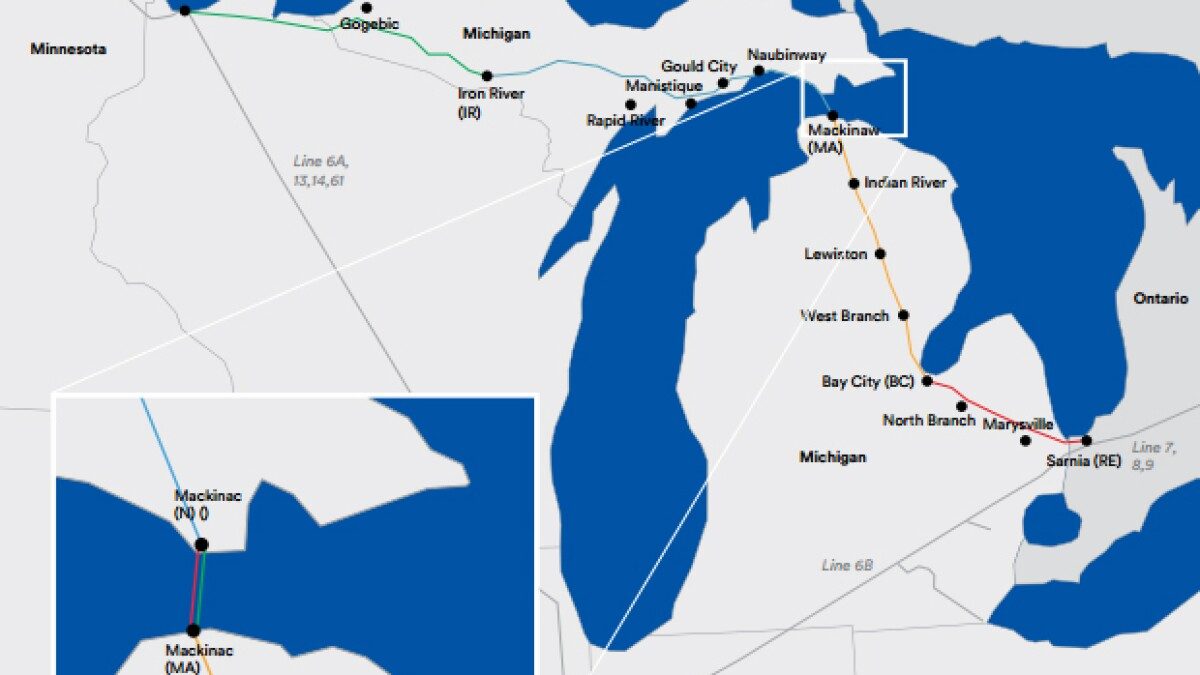

Two 20-inch oil pipelines have carried crude under the Straits of Mackinac since 1953, and Michigan has spent seven years trying to shut them down. On April 22, 2026, the United States Supreme Court unanimously ruled for Michigan Attorney General Dana Nessel, holding Enbridge's move to federal court was too late.
That leaves the shutdown fight in state court, though the case is stayed while a separate appeal by Governor Gretchen Whitmer and the Michigan Department of Natural Resources director is pending. Line 5 continues to operate. The tunnel meant to replace the lakebed pipes hit a separate obstacle: the Michigan Supreme Court vacated a state permit on July 31, and Whitmer paused other tunnel permits on November 24.
Why it matters
Line 5 moves 540,000 barrels a day through the Great Lakes; state permits and court forums now shape the shutdown fight.
Questions about this story
Free account needed to ask — your question is kept and asked for you right after sign-up. Answers are public.
No questions yet — be the first to ask.
Key Indicators
73
Years pipeline has operated
Line 5 began carrying oil and natural gas liquids under the Straits of Mackinac in 1953.
540K
Barrels per day capacity
Daily volume of light crude, synthetic crude, and natural gas liquids moving through the line.
4.5 mi
Underwater crossing
Length of the dual pipeline span resting on the lakebed between Lake Michigan and Lake Huron.
887
Days Enbridge waited to remove case
Time between service of Michigan's complaint and Enbridge's transfer to federal court—well past the 30-day statutory deadline.
1.1M
Gallons spilled since 1967
Documented Line 5 leaks across its 645-mile length, per Enbridge filings reviewed by federal regulators.
$500M+
Estimated tunnel project cost
Price tag for the proposed concrete tunnel that would encase the Straits crossing—originally projected for 2024 completion.
Images from Openverse under Creative Commons licenses.
Videos from YouTube.
Voices
Curated perspectives — historical figures and your fellow readers.
Andrew Carnegie
(1835-1919) ·Gilded Age · industry
Fictional AI pastiche — not real quote.
"Seven decades of steel beneath those waters, serving the nation faithfully, and yet Michigan would sooner trust a state courthouse than the very federal law that built this industrial civilization — the Supreme Court, with characteristic wisdom, has reminded ambitious governors that pipelines, like great enterprises, answer to a higher jurisdiction than local sentiment."
0% found this insightful
Sign up to generate historical perspectives on this story.
17 events
Latest: 3 days ago
Showing 8 of 17
JK to step
Tap a bar to jump to that date
Jump to
November 2026
Whitmer pauses Line 5 tunnel permits
LatestExecutive Action
Gov. Gretchen Whitmer directed the Michigan Department of Environment, Great Lakes, and Energy to suspend further work on resource and pending wastewater permits for the tunnel until legal questions are resolved. The order followed the state Supreme Court's decision vacating a separate permit from the Michigan Public Service Commission.
September 2026
Whitmer urges Enbridge CEO to shut Line 5
Political
Gov. Gretchen Whitmer called Line 5 a "ticking time bomb in the heart of the Great Lakes" and urged outgoing Enbridge CEO Gregory Ebel to shut it down "within months," according to the Associated Press.
July 2026
Michigan Supreme Court vacates tunnel permit
Legal
The court sided with tribes, held that the Public Service Commission's review should have included environmental harms and vacated the 2023 tunnel permit. The application went back for reconsideration.
State environmental regulators announce tunnel permit decision
Permit
The Michigan Department of Environment, Great Lakes, and Energy announced its permit decision for the proposed tunnel, according to the governor's office.
April 2026
Supreme Court rules Nessel case belongs in state court
Legal
Justices held that Enbridge's removal to federal court was too late and left the shutdown suit in Michigan state court. That case is stayed while a separate appeal by the governor and the state natural resources director is pending.
March 2026
Supreme Court denies Whitmer's sovereign immunity appeal
Legal
Justices decline to hear Michigan's claim that the governor cannot be sued in federal court over the easement revocation, leaving Enbridge's federal suit against her intact.
February 2026
Supreme Court hears oral arguments
Legal
Justices question both sides on whether equitable tolling applies to the federal removal statute. Argument leaves outcome unclear to most observers.
January 2026
Whitmer and natural resources director appeal stay order
Legal
Governor Gretchen Whitmer and the Michigan Department of Natural Resources director filed an appeal in Enbridge Energy, LP v. Whitmer. The state-court shutdown suit remains stayed until that appeal is resolved.
June 2024
Sixth Circuit sends Nessel case back to state court
Legal
Federal appeals court rules the 30-day removal deadline is not subject to equitable exceptions, ordering the case returned to Michigan state court.
June 2023
Bad River Band wins Wisconsin trespass ruling
Legal
Federal judge orders Enbridge to pay $5.15 million in damages and reroute Line 5 off Wisconsin tribal land by June 2026, creating an independent shutdown clock.
December 2021
Enbridge removes Nessel's case to federal court
Legal
887 days after being served, Enbridge moves the state-court shutdown suit to federal district court, citing changed circumstances. The deadline under federal law was 30 days.
November 2020
Enbridge sues Michigan in federal court
Legal
Company files in U.S. District Court for the Western District of Michigan, arguing federal pipeline safety law preempts the state easement revocation.
Whitmer revokes 1953 easement
Executive Action
Governor orders Line 5 shut by May 2021, citing what she calls incurable easement violations and unacceptable spill risk to the Great Lakes.
June 2019
Nessel files state-court suit to shut down Line 5
Legal
Michigan attorney general sues Enbridge in Ingham County Circuit Court, citing public trust doctrine and easement violations as grounds for shutdown.
January 2019
Whitmer and Nessel take office
Political
Both Democrats took office having campaigned on shutting Line 5, immediately reopening questions about the tunnel deal and the underlying easement.
Outgoing Republican Governor Rick Snyder signs an agreement with Enbridge to build a concrete tunnel beneath the Straits to encase the pipeline, projected at $500 million with a 2024 completion date.
1953
Line 5 enters service under Michigan easement
Construction
Enbridge's predecessor company completes the 645-mile pipeline, including twin 20-inch pipes resting on the Straits of Mackinac lakebed. The state easement requires specific safety conditions on coating, supports, and curvature.
Scenarios
1
Federal court rules pipeline-safety law preempts Michigan shutdown
Likely
Discussed by: U.S. Chamber of Commerce, Washington Legal Foundation, energy-law analysts at Bloomberg Law
In the separate federal suit over Whitmer's easement revocation, Enbridge presses the argument that the federal Pipeline Safety Act leaves no room for the state's shutdown order. A federal judge sided with Enbridge on a related theory in late 2025. That argument no longer controls Nessel's case, which the United States Supreme Court returned to state court in April 2026.
Discussed by: Enbridge, Michigan Public Service Commission, building trades unions
Before the November pause, Enbridge's proposed tunnel needed remaining state and federal permits. Now the company must return to the Michigan Public Service Commission after the state Supreme Court vacated the 2023 permit, and environmental regulators have paused other tunnel permits. If permitting restarts and construction follows, the new pipeline would replace the lakebed pipes while tribal treaty challenges continue.
3
Wisconsin reroute deadline forces shutdown of full line
Uncertain
Discussed by: Bad River Band, Earthjustice, Midwest Environmental Advocates
The June 2026 deadline from Judge William Conley's 2023 ruling has passed, with no full-line shutdown reported in the sources reviewed for this update. If the line still crosses tribal land without a valid easement, the Bad River dispute remains an independent shutdown trigger.
4
Negotiated settlement with phased shutdown
Unlikely
Discussed by: Bridge Michigan, regional energy analysts, former state officials
After years of parallel litigation that neither side is decisively winning, Michigan and Enbridge reach a negotiated framework: continued operation for a defined period (typically 5-10 years) tied to specific tunnel construction milestones, with hard shutdown dates if benchmarks slip. Tribal nations would need to be at the table for any settlement to hold up against treaty challenges.
Historical Context
3 moments from history that rhyme with this story — and how they unfolded.
1 of 3
April 2016 - February 2017
Dakota Access Pipeline and Standing Rock (2016-2017)
The Standing Rock Sioux Tribe and thousands of allied activists camped at the Cannonball River in North Dakota to block construction of the 1,172-mile Dakota Access Pipeline beneath Lake Oahe, the tribe's water source. The Obama administration paused the federal easement in December 2016; the Trump administration reversed course weeks later and the pipeline began operating in June 2017.
Then
Pipeline went into service over tribal objections after federal authority shifted between administrations. Standing Rock's legal challenges continued in federal court for years afterward.
Now
Established the modern template for tribal-rights pipeline opposition and showed how federal preemption can override both state and tribal objections. Also demonstrated how project economics can survive years of delay if a federal forum is willing to keep the line open.
Why this matters now
Like Line 5, Dakota Access turned on whether federal jurisdiction would override local and tribal sovereignty claims. Both fights show that for interstate pipelines, the choice of courtroom often determines the outcome before the merits are even argued.
2 of 3
September 2008 - June 2021
Keystone XL pipeline cancellation (2008-2021)
TC Energy's proposed 1,179-mile pipeline to carry Alberta tar sands crude to Nebraska faced 12 years of permitting fights, federal lawsuits, and tribal opposition. President Obama denied the cross-border presidential permit in 2015; President Trump reissued it in 2017; President Biden revoked it on his first day in office in 2021. TC Energy abandoned the project five months later.
Then
The project died after $9 billion in committed investment, with TC Energy writing off the loss.
Now
Showed that even fully-permitted interstate pipelines can be killed by sustained political pressure if a key federal authority swings against the project. But Keystone XL was a new pipeline still seeking approval—Line 5 already exists and operates, which is a much harder thing to undo.
Why this matters now
Keystone XL is the cautionary tale for Enbridge: federal authority can flip a project off as easily as on. But it also shows why Enbridge fights so hard for federal jurisdiction—the alternative, scattered state and tribal vetoes, is harder to manage politically than a single federal decision.
3 of 3
July 2010
Kalamazoo River oil spill (2010)
Enbridge's Line 6B pipeline ruptured near Marshall, Michigan, releasing more than 1 million gallons of diluted bitumen crude into Talmadge Creek and the Kalamazoo River. Operators in the control room initially misread alarms and restarted the line twice during the spill. Cleanup took five years and cost over $1.2 billion.
Then
Largest inland oil spill in U.S. history at the time. The National Transportation Safety Board issued a scathing report criticizing Enbridge's culture as one of 'pervasive organizational failures.'
Now
Became the foundational evidence cited in every subsequent challenge to Enbridge pipelines, including Line 5. Drove federal pipeline safety reforms but also entrenched the company's status as the case study for catastrophic pipeline failure.
Why this matters now
Every Line 5 shutdown argument draws on Kalamazoo as proof that Enbridge's spill-response capability cannot match the speed of a Straits of Mackinac rupture. The 2010 event is why Michigan officials treat the underwater crossing as a question of when, not if.
