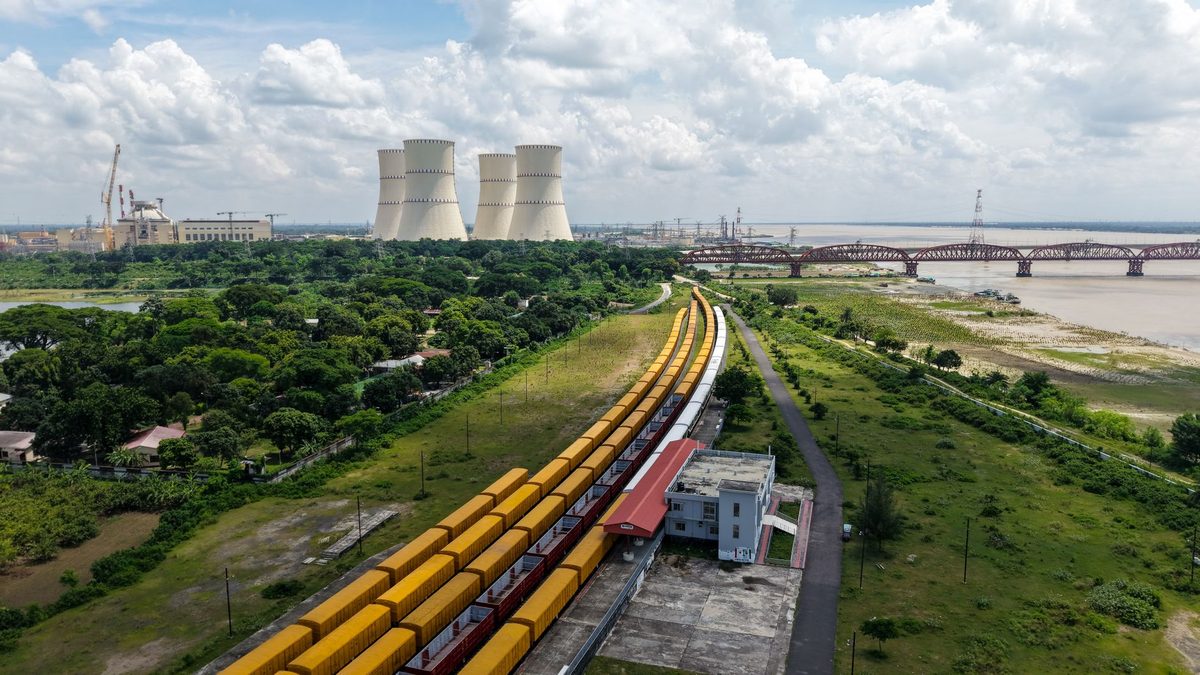

Bangladesh's first nuclear plant connects to the grid

Bangladesh's first nuclear plant connects to the grid

Built World Interactive

Rooppur Unit 1 completed a nearly 30-hour second grid test at about 320 megawatts; commercial operation still needs more tests and approvals.

Overview

Updated Yesterday

Unit 1 ended its second grid test at 5:05 p.m. on Nov. 24 after almost 30 hours, longer than planned. It fed about 320 megawatts to Bangladesh's national grid and delivered electricity worth about 70.6 million taka (Tk 7.06 crore), the operator said.

Engineers are checking operating readings, turbine-generator performance and equipment; Nuclear Power Plant Company Bangladesh Limited (NPCBL) says the findings will guide the next steps. The plant is not yet in commercial operation; further power increases need approval from the Bangladesh Atomic Energy Regulatory Authority before the government's early-2027 target for full 1,200-megawatt output. Under the Russian contract, commercial supply is planned after 10 months of trials, and the eighth of nine planned uranium shipments arrived on Nov. 24.

Why it matters

Bangladesh has fed nuclear power into its grid twice; Rooppur's two units are set to add 2,400 megawatts.

Who makes nuclear power

Bangladesh is only the fourth country in 30 years to start making nuclear power

Each step is a country's first reactor feeding its power grid. 32 countries and Taiwan did it by 1996; since then only Iran, the UAE, Belarus and Bangladesh.

Bangladesh 2026
19542026

37

countries ever, Taiwan included by 2026

  • 2026 Bangladesh
  • 2020 Belarus, UAE
  • 2011 Iran
  • 1996 Romania
  • 1991 China
  • 1989 Mexico
Bangladesh is only the fourth country in 30 years to start making nuclear power
NameYearSource
Russia1954IAEA PRIS: reactors in Russia (grid dates)
Britain1956IAEA PRIS: reactors in Britain (grid dates)
United States1957IAEA PRIS: reactors in United States (grid dates)
France1959IAEA PRIS: reactors in France (grid dates)
Germany1961IAEA PRIS: reactors in Germany (grid dates)
Belgium1962IAEA PRIS: reactors in Belgium (grid dates)
Canada1962IAEA PRIS: reactors in Canada (grid dates)
Italy1963IAEA PRIS: reactors in Italy (grid dates)
Japan1963IAEA PRIS: reactors in Japan (grid dates)
Sweden1964IAEA PRIS: reactors in Sweden (grid dates)
Netherlands1968IAEA PRIS: reactors in Netherlands (grid dates)
Spain1968IAEA PRIS: reactors in Spain (grid dates)
Switzerland1968IAEA PRIS: reactors in Switzerland (grid dates)
India1969IAEA PRIS: reactors in India (grid dates)
Pakistan1971IAEA PRIS: reactors in Pakistan (grid dates)
Slovakia1972IAEA PRIS: reactors in Slovakia (grid dates)
Kazakhstan1973IAEA PRIS: reactors in Kazakhstan (grid dates)
Argentina1974IAEA PRIS: reactors in Argentina (grid dates)
Bulgaria1974IAEA PRIS: reactors in Bulgaria (grid dates)
Armenia1976IAEA PRIS: reactors in Armenia (grid dates)
Finland1977IAEA PRIS: reactors in Finland (grid dates)
South Korea1977IAEA PRIS: reactors in South Korea (grid dates)
Taiwan1977IAEA PRIS: reactors in China and Taiwan (grid dates)
Ukraine1977IAEA PRIS: reactors in Ukraine (grid dates)
Slovenia1981IAEA PRIS: reactors in Slovenia (grid dates)
Brazil1982IAEA PRIS: reactors in Brazil (grid dates)
Hungary1982IAEA PRIS: reactors in Hungary (grid dates)
Lithuania1983IAEA PRIS: reactors in Lithuania (grid dates)
South Africa1984IAEA PRIS: reactors in South Africa (grid dates)
Czech Republic1985IAEA PRIS: reactors in Czech Republic (grid dates)
Mexico1989IAEA PRIS: reactors in Mexico (grid dates)
China1991IAEA PRIS: reactors in China and Taiwan (grid dates)
Romania1996IAEA PRIS: reactors in Romania (grid dates)
Iran2011IAEA PRIS: reactors in Iran (grid dates)
Belarus2020IAEA PRIS: reactors in Belarus (grid dates)
UAE2020IAEA PRIS: reactors in UAE (grid dates)
Bangladesh2026World Nuclear Association: Rooppur 1 grid connection in Bangladesh

As of 2026-11-24. Year each country's first power reactor fed its grid, per the IAEA reactor database (PRIS). Includes countries that later shut every reactor (Italy, Germany, Lithuania, Kazakhstan). Russia includes the Soviet 1954 plant. China = mainland. Bangladesh, not in PRIS yet: World Nuclear Association. Sources: IAEA PRIS: reactors in Russia (grid dates), IAEA PRIS: reactors in Britain (grid dates), IAEA PRIS: reactors in United States (grid dates), IAEA PRIS: reactors in France (grid dates), IAEA PRIS: reactors in Germany (grid dates), IAEA PRIS: reactors in Belgium (grid dates) and 30 more, each cited on its row.

Questions about this story

Free account needed to ask — your question is kept and asked for you right after sign-up. Answers are public.

No questions yet — be the first to ask.

Key Indicators

375 MW
Peak first-trial output
Unit 1 peaked at 375 megawatts during its first grid test on Nov. 17.
About 320 MW
Second-grid-test output
Unit 1 fed about 320 megawatts for nearly 30 hours in its second grid test, ending Nov. 24.
Tk 7.06 crore
Electricity delivered in second test
The operator valued the second run's electricity at about 70.6 million taka.
8 of 9
Russian fuel shipments received
One shipment for Unit 1 refuelling and seven for Unit 2 had arrived by Nov. 24; nine are planned.
2,400 MW
Total plant capacity (two units)

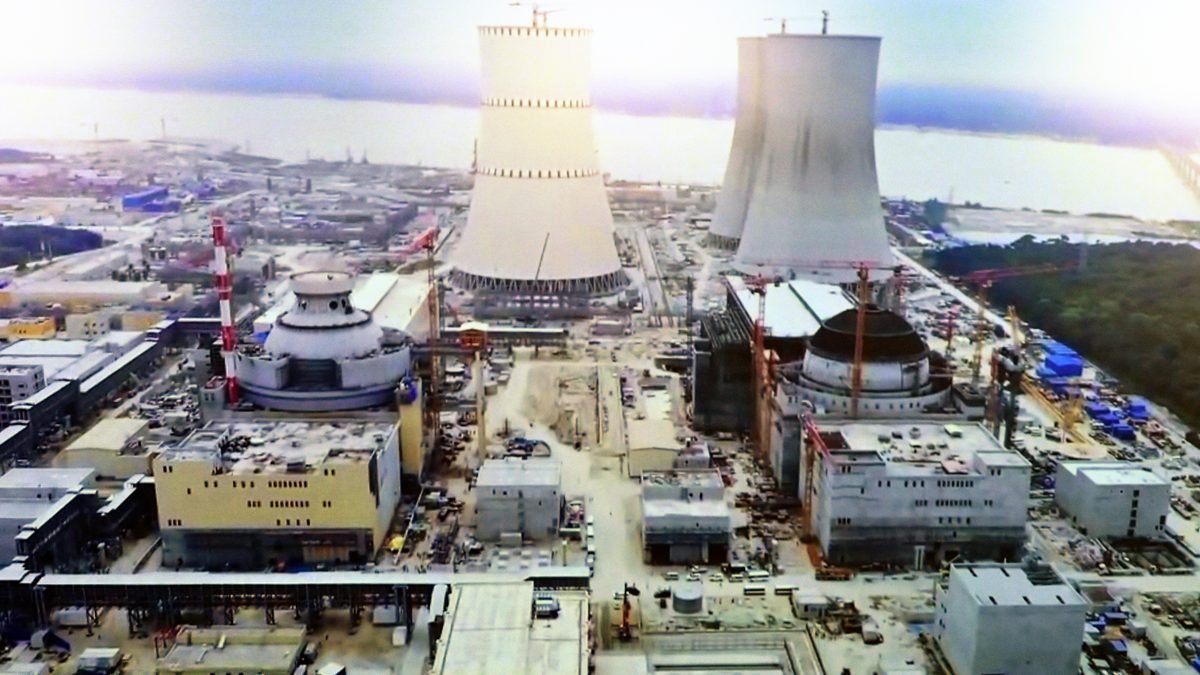

The plant has two VVER-1200 reactors.
February 2027
Government commercial-operation target
The government aims to reach full output by then; the Russian contract plans commercial supply after 10 months of trials.
First
Bangladesh's first nuclear plant
Unit 1 gave Bangladesh its first nuclear grid supply on Nov. 17.

Voices

Curated perspectives — historical figures and your fellow readers.

Sign up to generate historical perspectives on this story.

People Involved

Organizations Involved

Timeline

2011 November 2026

15 events Latest: Yesterday Showing 8 of 15
Tap a bar to jump to that date
  1. Eighth Russian fuel shipment arrives

    Latest Fuel Delivery

    Three trucks carried the consignment into the Ishwardi site under army and law-enforcement security. The project has now received eight of nine planned Russian shipments, including one for Unit 1 refuelling and seven for Unit 2.

  2. Second grid test ends after nearly 30 hours

    Trial Operation

    Unit 1 was disconnected from the national grid after nearly 30 hours supplying about 320 megawatts. The test delivered electricity worth about Tk 7.06 crore; engineers then began checking operating parameters, turbine-generator performance and related equipment.

  3. Unit 1 begins second trial grid supply

    Trial Operation

    Unit 1 resumed supplying 300-350 MW to the national grid for tests expected to last 10 to 24 hours. Project Director Dr Md Kabir Hossain said engineers would check the generation system and its operation with the grid.

  4. Unit 1 connects to national grid

    Milestone

    Rooppur Unit 1 supplied its first electricity to the national grid at 3:16pm, reaching 350 MW before operators reduced output to 300 MW for stability tests.

  5. First trial grid supply ends after 8 hours 34 minutes

    Trial Operation

    Unit 1 generated a maximum of 375 MW before the grid disconnection at 11:50pm. It had supplied power for 8 hours 34 minutes, after being reduced to 300 MW for grid stability and later raised gradually.

  6. Unit 1 begins power generation process

    Milestone

    Operators began raising reactor pressure and temperature, starting the C-stage tests that lead to electricity generation.

  7. BAERA approves C-stage power start-up

    Regulatory

    The regulator allowed Unit 1 to enter the final stage of raising reactor power, clearing the way for turbine-generator tests.

  8. Rosatom completes automated process control systems installation

    Milestone

    Rosatom announced completion of installation of automated process control systems at both Rooppur units.

  9. Unit 1 achieves first criticality

    Milestone

    Unit 1 begins a self-sustaining chain reaction at 3:34pm; BAERA starts an inspection of the reactor's readiness.

  10. Minister meets Rosatom chief in Moscow

    Diplomacy

    Science minister Fakir Mahbub Anam meets Rosatom DG Alexey Likhachev; Rosatom targets late-November power generation.

  11. Regulator approves fission start

    Regulatory

    BAERA grants B2 sub-stage authorization, permitting Unit 1 to begin its first controlled fission reaction.

  12. First fuel consignment for Unit 2 arrives

    Milestone

    The first nuclear fuel for Rooppur Unit 2 arrived at the site, moving the second reactor closer to its own commissioning.

  13. Safety valve defects delay fission start

    Setback

    Defects found in safety valve tests push the planned September start of fission to a later date.

  14. Fuel loading begins at Unit 1

    Milestone

    Rosatom's engineering division begins loading nuclear fuel into Unit 1's reactor vessel.

  15. Bangladesh, Russia sign Rooppur deal

    Agreement

    Bangladesh and Russia sign an intergovernmental agreement for the 2,400 MW Rooppur plant, with Rosatom as constructor.

Scenarios

1

Rooppur Unit 1 feeds 300 MW into Bangladesh's grid by December

Likely Resolves by End of 2026

Discussed by: Rosatom Director General Alexey Likhachev and NPCBL officials, who told reporters trial grid supply could start in late November or December.

This happened on Nov. 17, when Unit 1 supplied 300-350 megawatts for eight hours and 34 minutes. A second run on Nov. 23 delivered about 320 megawatts for nearly 30 hours before disconnection on Nov. 24.

2

Commissioning delays push Rooppur's grid connection into 2027

Possible Resolves by Feb 1, 2027

Discussed by: Project officials quoted by The Business Standard, who note the timeline is not fixed and could stretch to 10 weeks from mid-October.

The first grid connection already happened on Nov. 17, so later slips would affect higher output or commercial operation, not the initial connection. The process had already slipped once when safety-valve defects pushed fission from September to October.

3

Rooppur Unit 1 reaches full commercial operation

Uncertain Resolves by End of 2027

Discussed by: Rosatom, which expects trial operations to continue seven to eight months before commercial declaration.

After the trial period — which officials say could run seven to eight months — the reactor must demonstrate sustained performance at or near its 1,200 MW design capacity. Full commercial operation is the formal end of the commissioning arc, likely in the second half of 2027.

4

Rooppur Unit 1 reaches full commercial operation by February 2027

Possible Resolves by Feb 28, 2027

Discussed by: Science and Technology Minister Fakir Mahbub Anam

The government aims to raise Unit 1 to its full 1,200 MW and declare commercial operation in February 2027. Trial runs and reliability tests continue through December and January, and BAERA must approve each stage.

5

Rooppur Unit 1 enters a 10-month trial period before commercial supply

Possible Resolves by Sep 17, 2027

Discussed by: The Financial Express, citing the agreement with the Russian contractor

Project sources say trial runs are following International Atomic Energy Agency guidelines. The agreement with the Russian contractor plans commercial electricity supply from Unit 1 after 10 months of trial operation.

Historical Context

2 moments from history that rhyme with this story — and how they unfolded.

2020–2021

UAE Barakah Unit 1 (2020–2021)

The United Arab Emirates built the Arab world's first nuclear plant at Barakah with South Korean technology from KEPCO. Unit 1 loaded fuel in early 2020, reached criticality that year, and connected to the grid in April 2021 — roughly a year after fuel loading began.

Then

The UAE grid took on its first nuclear power, starting with a single unit before ramping the rest of the four-reactor plant.

Now

The UAE says Barakah can supply up to a quarter of its electricity, and the program became a template for first-time nuclear countries in the region.

Why this matters now

Barakah shows the typical path for a first-time nuclear country: a foreign-built reactor, staged regulatory approvals, and a gradual ramp from first criticality to grid supply.

September 2011

Iran Bushehr (2011)

Russia completed Iran's Bushehr plant after German contractor Siemens abandoned the project following the 1979 revolution. The VVER-1000 reactor was connected to the grid in September 2011, decades after construction began.

Then

Bushehr added roughly 1,000 megawatts gross to Iran's grid, its first nuclear generation.

Now

Iran remains the only Middle Eastern country operating a Russian-built reactor, and Bushehr became a fixture in nuclear diplomacy.

Why this matters now

Like Rooppur, Bushehr is a Russian-built VVER reactor at the center of a national power program — though Rooppur's commissioning has moved far faster since fuel loading began in April 2026.
