Underwater data centers move from prototype to commercial buildout

Underwater data centers move from prototype to commercial buildout

Built World

Shanghai's wind-powered subsea facility goes live as partners commit to a 500-megawatt cluster

May 9th, 2026: Shanghai brings world's first wind-powered subsea data center online

Overview

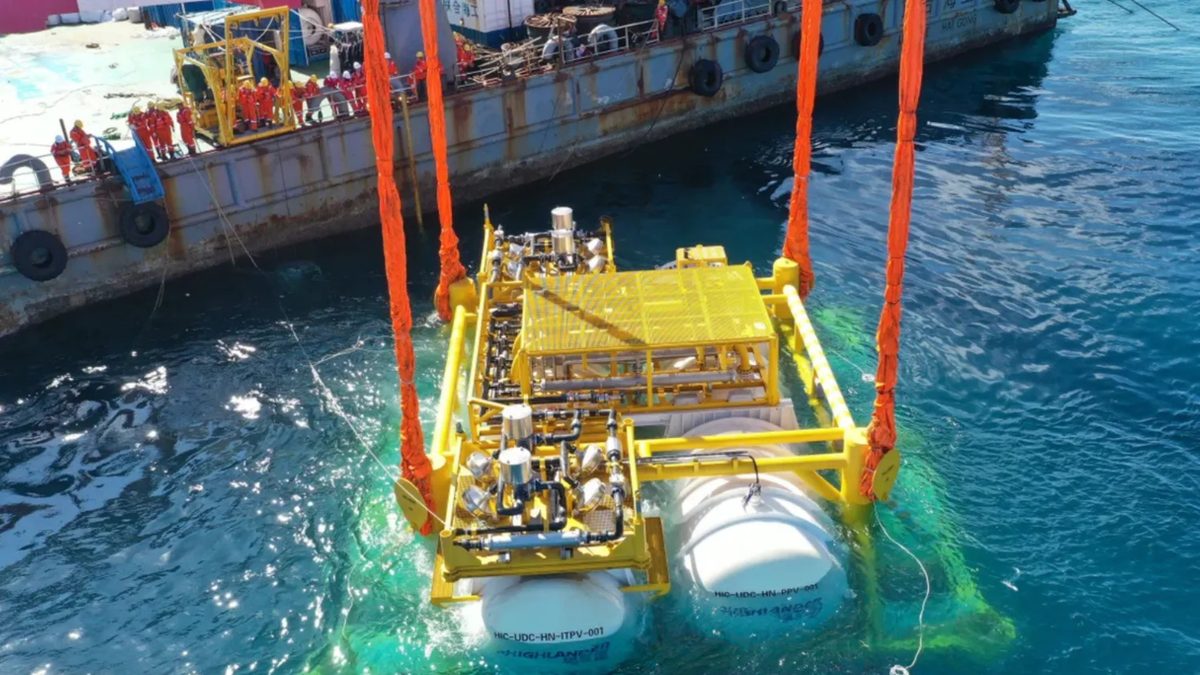

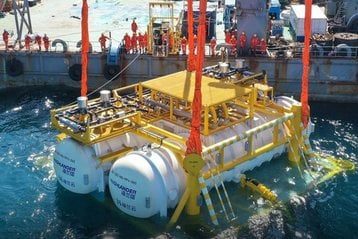

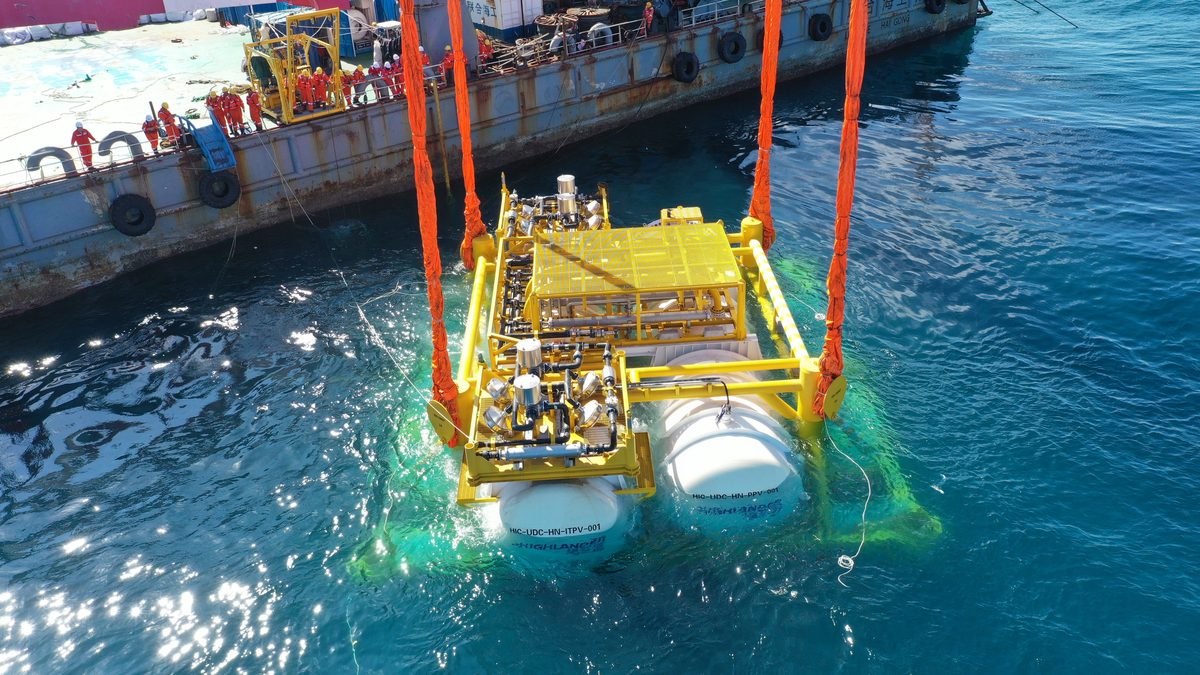

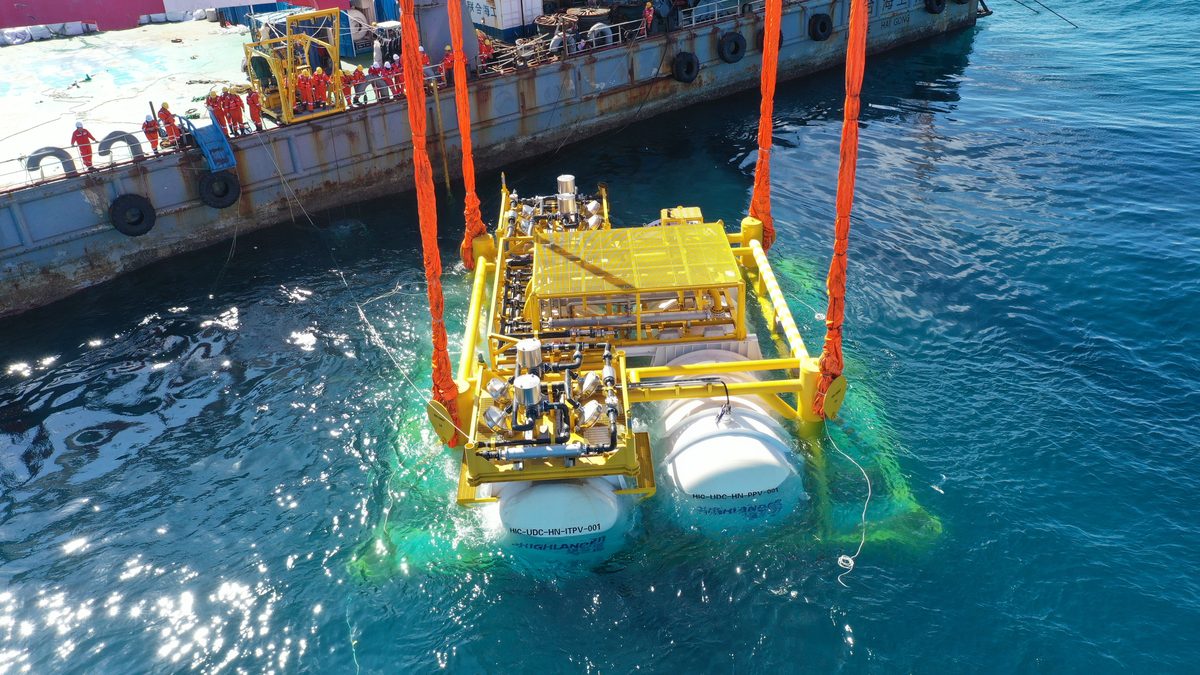

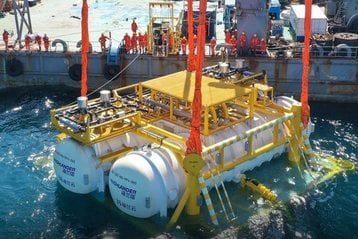

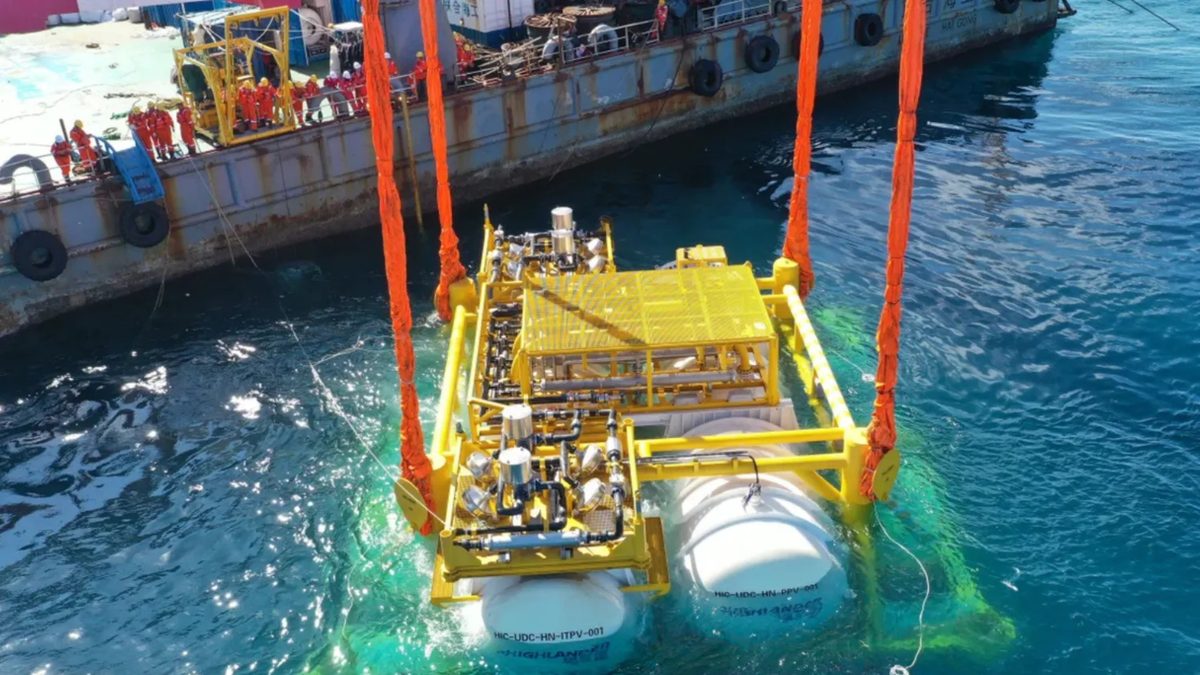

A sealed steel capsule sits on the seabed off Shanghai's Nanhuizui coast, drawing more than 95% of its power from offshore wind turbines and using cold seawater to cool its servers. It is the world's first wind-powered underwater data center, and its operators have signed deals to scale the design into a 500-megawatt cluster.

The land-based grid is no longer the only path. Oregon startup Panthalassa raised $140 million in early May to build wave-powered floating ocean compute nodes. Peter Thiel led the round; Marc Benioff, Max Levchin, and John Doerr also invested, valuing the company near $1 billion.

Why it matters

AI's power and water demands are outrunning the grid; subsea data centers point to a way around both bottlenecks at once.

Questions about this story

No questions yet — be the first to ask.

Play on this story Voices Debate Predict

Key Indicators

1.15
Power Usage Effectiveness (PUE)
Ratio of total facility power to server power. The global average for land-based data centers is about 1.5; lower is better.
95%+
Share of electricity from offshore wind
Direct supply from nearby turbines, with grid backup for the remainder.
500 MW
Planned cluster capacity
Target size of the follow-on subsea cluster agreed by Hicloud, Shenergy, China Telecom, and CCCC.
0
Liters of freshwater used for cooling
Seawater replaces the millions of liters a comparable land facility would consume each year.
22.8%
Reduction in total power consumption
Operator estimate versus an equivalent land-based facility, driven mostly by passive seawater cooling.
12,000 t
Annual carbon emissions cut
Operator estimate of CO₂ avoided each year compared with a land-based equivalent on China's grid mix.

Voices

Curated perspectives — historical figures and your fellow readers.

Ever wondered what historical figures would say about today's headlines?

Sign up to generate historical perspectives on this story.

Play

Exploring all sides of a story is often best achieved with Play.

Log in to play. Track your picks, climb the leaderboards. Log in Sign Up
Predict 4 ways this could play out. Contrarian picks score more — points lock when the scenario resolves. Log in to play
Timeline Five events from this story — drag them oldest to newest. Log in to play
Connections Sixteen names from the news. Find the four hidden groups of four. Log in to play

People Involved

Organizations Involved

Shanghai Hicloud Technology
Shanghai Hicloud Technology
Cloud and data center operator
Operator of the Lin-gang underwater data center

The Shanghai-based cloud operator running the Lin-gang underwater data center and leading the planned 500-megawatt cluster.

Shenergy Group
Shenergy Group
Shanghai municipal energy company
Power partner supplying offshore wind to the Lin-gang facility

Shanghai's main municipal energy group, supplying the offshore wind power that drives the Lin-gang underwater data center.

China Communications Construction Company (CCCC)
China Communications Construction Company (CCCC)
State-owned infrastructure contractor
Marine construction partner for the subsea capsules

China's largest port and marine engineering contractor, building and installing the subsea capsules for the Lin-gang project.

Highlander (Hainan Highlander Information Technology)
Highlander (Hainan Highlander Information Technology)
Subsea data center developer
Operator of the Hainan underwater data center, the Chinese precursor to Lin-gang

The company behind China's first commercial underwater data center off Hainan, which proved out the basic capsule design later scaled at Lin-gang.

Microsoft
Microsoft
Public technology company
Concluded research project; technical precedent for current buildout

Microsoft's research program that ran a sealed, server-filled capsule on the Scottish seabed for two years and showed it outperformed land-based equivalents on reliability.

PA
Panthalassa
Ocean data center startup
Pre-commercial; Ocean-3 pilot deployments planned for 2026

Oregon-based startup building wave-powered floating ocean compute nodes for AI workloads, backed by Peter Thiel, Marc Benioff, Max Levchin, and John Doerr.

Timeline

January 2014 May 2026

7 events Latest: May 9th, 2026 · 2 months ago
Tap a bar to jump to that date
  1. Shanghai brings world's first wind-powered subsea data center online

    Latest Deployment

    Hicloud confirms the Lin-gang underwater data center is operating off Nanhuizui, drawing more than 95% of its power from offshore wind and reporting a Power Usage Effectiveness (PUE) below 1.15.

  2. Partners commit to 500-megawatt subsea cluster

    Commercial deal

    Hicloud, Shenergy Group, China Telecom, and China Communications Construction Company sign agreements to scale the Lin-gang design into a 500 MW offshore wind-powered subsea data center cluster.

  3. Panthalassa raises $140M to build wave-powered floating ocean data centers

    Funding

    Oregon-based Panthalassa raises $140 million in a Series B led by Peter Thiel, pushing the company's valuation near $1 billion. Its 85-metre steel floating nodes generate power from wave motion, cool onboard AI hardware with seawater, and send data back via low-Earth-orbit satellites.

  4. First commercial underwater data module deployed in Hainan

    Deployment

    Highlander drops the first commercial underwater data module off Hainan's Lingshui coast, beginning China's move from research to paying workloads.

  5. Microsoft retrieves Natick capsule with strong reliability result

    Research result

    Microsoft pulls the Northern Isles capsule back up. Server failure rate is one-eighth that of an identical land-based control, validating the sealed-environment thesis.

  6. Microsoft sinks Northern Isles capsule off Scotland

    Deployment

    A 40-foot pressurized capsule with 855 servers is lowered onto the seabed near the Orkney Islands for a two-year endurance test.

  7. Microsoft begins Project Natick

    Research

    Microsoft Research starts a multi-year program to test whether commercial servers can run reliably inside sealed, seabed-mounted capsules.

Historical Context

3 moments from history that rhyme with this story — and how they unfolded.

August 2018 – September 2020

Microsoft Project Natick (2018–2020)

Microsoft Research lowered a 40-foot sealed capsule containing 855 servers onto the seabed off Scotland's Orkney Islands. After two years underwater, the team retrieved the capsule and counted failures. Servers inside had failed at one-eighth the rate of an identical control rack on land.

Then

Microsoft never turned Natick into a commercial product. The reliability data was the headline takeaway and the press cycle moved on within months.

Now

Every serious underwater data center proposal since, including Hainan and now Shanghai Lin-gang, leans on Natick's reliability numbers as proof the basic engineering works.

Why this matters now

Lin-gang is the first commercial-scale answer to the question Natick raised but never resolved: can sealed subsea capsules carry real production workloads, not just a research demo? The Shanghai project is essentially Natick built for paying customers and tied to offshore wind.

2010 – 2020

UK offshore wind scale-up (2010–2020)

British offshore wind grew from a few hundred megawatts of pilot projects to more than 10 gigawatts of installed capacity in a decade. Costs fell roughly 70% as turbine size, installation vessels, and seabed cabling matured. Projects like Hornsea One showed gigawatt-class offshore farms were buildable on commercial terms.

Then

Offshore wind moved from subsidy-heavy demonstration to one of the cheapest new sources of power in the UK by the late 2010s.

Now

It set the template for marine industrial buildout: a few state-backed pilots, then a contractor base (vessels, cable layers, port hubs) that could replicate sites quickly. China's offshore wind sector now plays the same role for projects like Lin-gang.

Why this matters now

The 500 MW Lin-gang cluster only pencils out because Shanghai's offshore wind is already cheap and the marine contractor base (CCCC and others) is in place. The same conditions that made gigawatt-class offshore wind routine are what make subsea data centers thinkable now.

December 2022

Hainan underwater data center launch (2022)

Highlander dropped the first commercial underwater data module off Lingshui, on the south coast of Hainan island. The pod ran live cloud workloads on the seabed, becoming the first paying subsea data center anywhere. More modules followed over the next two years.

Then

Hainan proved the operating model on a small scale and gave Chinese regulators a working facility to permit and study.

Now

It set the engineering and regulatory baseline that the Shanghai Lin-gang project, larger and tied to offshore wind, builds directly on.

Why this matters now

Lin-gang is the second act. Hainan showed that capsules could host real workloads; Shanghai is the test of whether the model scales with renewable power and a hyperscale plan attached.
