America's first new nuclear reactors in a generation

America's first new nuclear reactors in a generation

Built World

Georgia's Vogtle Units 3 and 4 Complete After Massive Delays and Cost Overruns

April 29th, 2024: Unit 4 Enters Commercial Operation

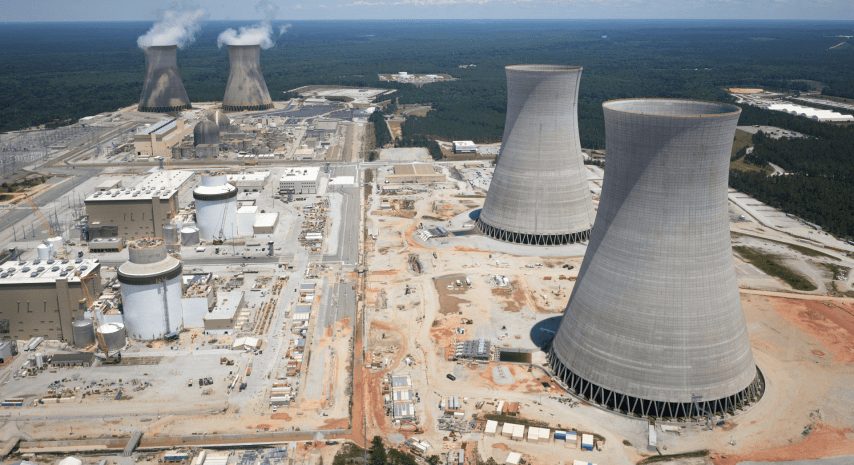

Overview

The United States had not completed a new nuclear reactor from scratch since the 1970s. On April 29, 2024, Vogtle Unit 4 entered commercial operation in Georgia, joining its sister Unit 3 which came online in July 2023.

Together, they're the first new American nuclear reactors built in over 30 years and make Plant Vogtle the largest generator of carbon-free electricity in the nation. The achievement came at extraordinary cost. What was projected to take five years and $14 billion ultimately required 15 years and $35 billion.

Westinghouse, the reactor designer, filed for bankruptcy mid-construction. A parallel project in South Carolina using the same AP1000 reactor design was abandoned entirely in 2017, leaving ratepayers paying for reactors that will never generate electricity. Georgia saw it through, and now 4,800 megawatts of emissions-free baseload power will run for 60 to 80 years.

Play on this story Voices Debate Predict

Key Indicators

$35B
Final project cost
More than double the original $14 billion budget
4,800 MW
Total generation capacity
All four Vogtle units combined, largest nuclear plant in the US
30+ years
Gap since last new reactor
First new US nuclear construction since the 1970s to reach completion
10M tons
Annual CO2 emissions avoided
Units 3 and 4 alone displace significant fossil fuel generation

Voices

Curated perspectives — historical figures and your fellow readers.

Ever wondered what historical figures would say about today's headlines?

Sign up to generate historical perspectives on this story.

Play

Exploring all sides of a story is often best achieved with Play.

Log in to play. Track your picks, climb the leaderboards. Log in Sign Up
Predict 3 ways this could play out. Contrarian picks score more — points lock when the scenario resolves. Log in to play
Timeline Five events from this story — drag them oldest to newest. Log in to play
Connections Sixteen names from the news. Find the four hidden groups of four. Log in to play

People Involved

Organizations Involved

Timeline

January 2006 April 2024

13 events Latest: April 29th, 2024 · 2 years ago Showing 8 of 13
Tap a bar to jump to that date
  1. Unit 4 Enters Commercial Operation

    Latest Milestone

    Vogtle Unit 4 began commercial operation, completing the project. Plant Vogtle became the largest nuclear power plant in the United States with 4,800 MW total capacity.

  2. Unit 4 Connects to Grid

    Milestone

    Vogtle Unit 4 synchronized to the power grid for the first time, beginning the final testing phase before commercial operation.

  3. PSC Approves Cost Recovery

    Regulatory

    Georgia Public Service Commission approved passing $7.56 billion of $10.2 billion in cost overruns to ratepayers, with Georgia Power absorbing the remainder.

  4. Unit 3 Enters Commercial Operation

    Milestone

    Vogtle Unit 3 began commercial operation, the first new nuclear reactor completed in the United States since Watts Bar 2 in 2016.

  5. Georgia Decides to Continue

    Decision

    Georgia Power and project partners voted to continue Vogtle construction despite Westinghouse bankruptcy and the South Carolina abandonment.

  6. V.C. Summer Project Abandoned

    Industry

    South Carolina utilities abandoned their parallel AP1000 project after spending $9 billion, leaving Georgia's Vogtle as the only surviving US AP1000 construction.

  7. Westinghouse Files for Bankruptcy

    Financial

    Westinghouse filed for Chapter 11 bankruptcy protection, crippled by losses from Vogtle and V.C. Summer projects. Parent company Toshiba faced massive liabilities.

  8. Westinghouse Takes Direct Control

    Management

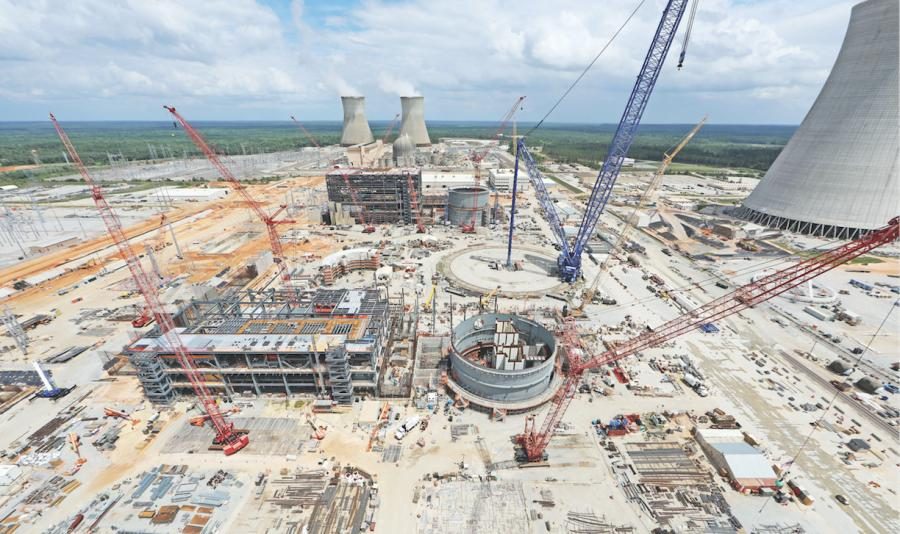

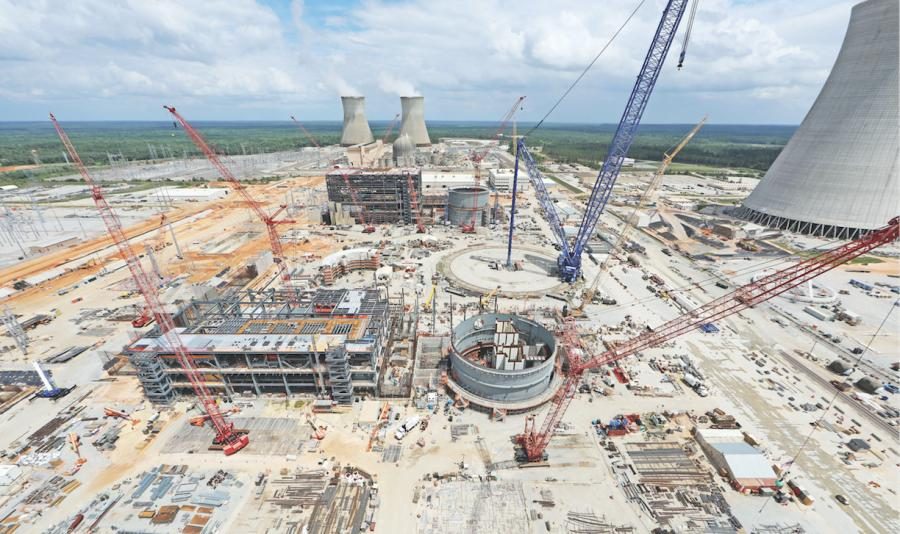

    After ongoing delays and cost increases, Westinghouse replaced CB&I/Shaw as primary contractor, taking direct control of construction with Fluor handling day-to-day work.

  9. First Concrete Poured for Unit 4

    Construction

    Safety-related concrete placement began for Unit 4's nuclear island.

  10. First Concrete Poured for Unit 3

    Construction

    Construction officially began with the first safety-related concrete placement for Unit 3's nuclear island.

  11. NRC Issues Combined License

    Regulatory

    Nuclear Regulatory Commission issued combined construction and operating licenses for Units 3 and 4, the first new reactor licenses in the US since 1978.

  12. Georgia PSC Approves Vogtle Expansion

    Regulatory

    Georgia Public Service Commission approved construction of two AP1000 reactors, projected to cost $14 billion and begin operation in 2016-2017.

  13. AP1000 Reactor Design Certified

    Regulatory

    The Nuclear Regulatory Commission certified Westinghouse's AP1000 reactor design, enabling its use in new US plants.

Historical Context

3 moments from history that rhyme with this story — and how they unfolded.

1973-1989

Shoreham Nuclear Power Plant (1973-1989)

Long Island Lighting Company built a complete 820 MW nuclear reactor at Shoreham, New York. Originally budgeted at $65-75 million with a 1973 completion date, costs ballooned to $6 billion by 1989. Local opposition and evacuation planning disputes prevented the plant from ever operating commercially.

Then

LILCO sold the finished plant to the state for $1 in 1989 and agreed never to operate it. The reactor was decommissioned without generating commercial power.

Now

Long Island ratepayers paid for the unused plant for decades. Shoreham became a symbol of nuclear project risk and contributed to the decades-long pause in US reactor construction.

Why this matters now

Shoreham demonstrated how political and regulatory opposition could doom a completed reactor. Vogtle faced similar cost escalation but had stronger political support from Georgia officials who stayed committed through the overruns.

1973-2016

Watts Bar Unit 2 (1973-2016)

Tennessee Valley Authority began constructing Watts Bar Unit 2 in 1973 but halted work in 1985 with the reactor 60% complete and $1.7 billion spent. TVA resumed construction in 2007 and finally completed the unit in 2015 at a total cost of $4.7 billion.

Then

Unit 2 began commercial operation in October 2016, becoming the first new US reactor since 1996.

Now

Watts Bar 2 proved that mothballed nuclear projects could be revived, but the 43-year construction timeline underscored the challenges of starting and stopping major nuclear work.

Why this matters now

When Westinghouse's bankruptcy threatened to derail Vogtle in 2017, Southern Company chose to press forward rather than risk a Watts Bar-style decades-long pause. The decision to continue proved critical to eventual completion.

2013-2017

V.C. Summer Units 2 and 3 (2013-2017)

South Carolina utilities SCANA and Santee Cooper began building two AP1000 reactors identical to Vogtle's at the V.C. Summer plant. After $9 billion spent and with reactors partially built, the utilities abandoned the project in July 2017 following Westinghouse's bankruptcy.

Then

800,000 South Carolina ratepayers were left paying for reactors that would never generate power. SCANA was acquired by Dominion Energy amid scandal and lawsuits.

Now

Customers still pay about $8 monthly for the abandoned project, with 15 years of payments remaining. Former Westinghouse executives faced fraud charges for concealing construction problems.

Why this matters now

V.C. Summer's abandonment made Vogtle the only surviving US AP1000 project. Georgia's decision to continue when South Carolina quit was the turning point that determined whether America would have any new large-scale nuclear capacity.
